Dripping Springs High School Renovations: Construction continues in the A wing of Dripping Springs High School, where more than 20 classrooms are undergoing renovations this semester. Work is expected to be completed in December, allowing teachers to return to the renovated spaces for the spring semester!
Dripping Springs Elementary Exterior Waterproofing: The exterior waterproofing project at Dripping Springs Elementary includes replacing damaged wall elements, adding wall cavity and exterior insulation, and replacing exterior windows, masonry, and exterior lighting. Window replacement is expected to be completed in approximately one month, while masonry work is projected to wrap up in late January.
18 days ago, DSISD Communications
Construction progress at Driftwood Springs High School:

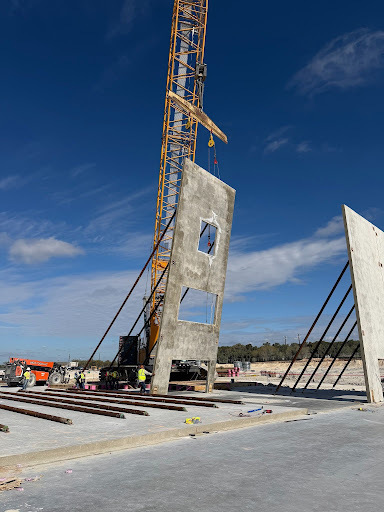

• Tiltwall is 95% complete

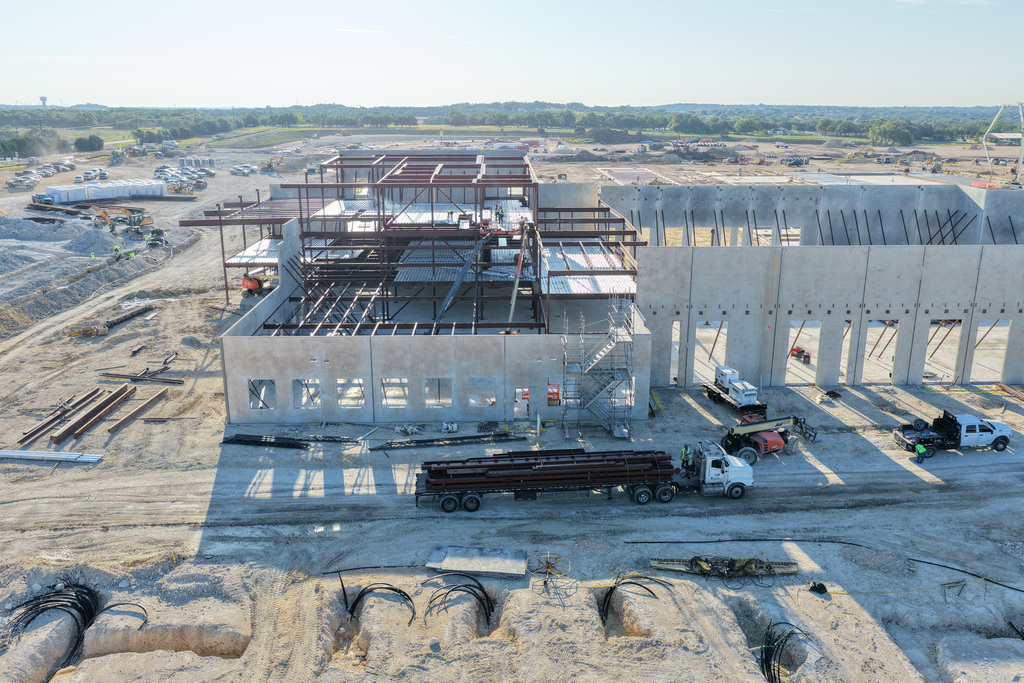

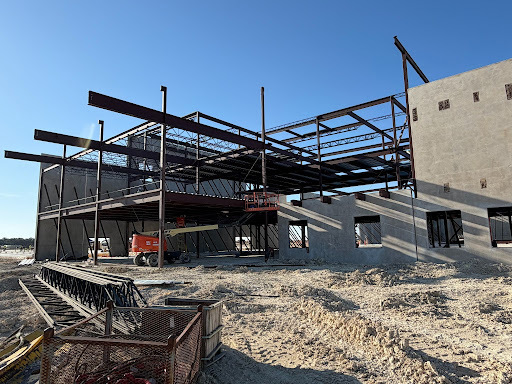

• Framing and in-wall mechanical, electrical and plumbing work in the A.2 wing is 75% complete
• Overhead mechanical, electrical and plumbing in the cafeteria is underway
• Painting is nearing completion in the administration wing
• CMU (Concrete Masonry Unit) walls in the fine arts wing are 50% complete
• CMU walls in the athletics wing have begun
• Underground utilities are nearly complete
• Underground electrical infrastructure is 75% complete
18 days ago, DSISD Communications
Construction crews are making great progress on the 18+ Program Facility on Sawyer Ranch Road, next to the Sycamore Springs campuses! Last week, the DSISD Board of Trustees toured the facility to see the progress firsthand. Approved by voters as part of the 2023 Bond, the project continues to take shape. Window installation is complete, roofing is nearing completion, and crews are currently installing HVAC, plumbing and electrical systems. The project is projected to be completed in late December. We look forward to seeing this new space come together to better serve our 18+ Program students!
18 days ago, DSISD Communications

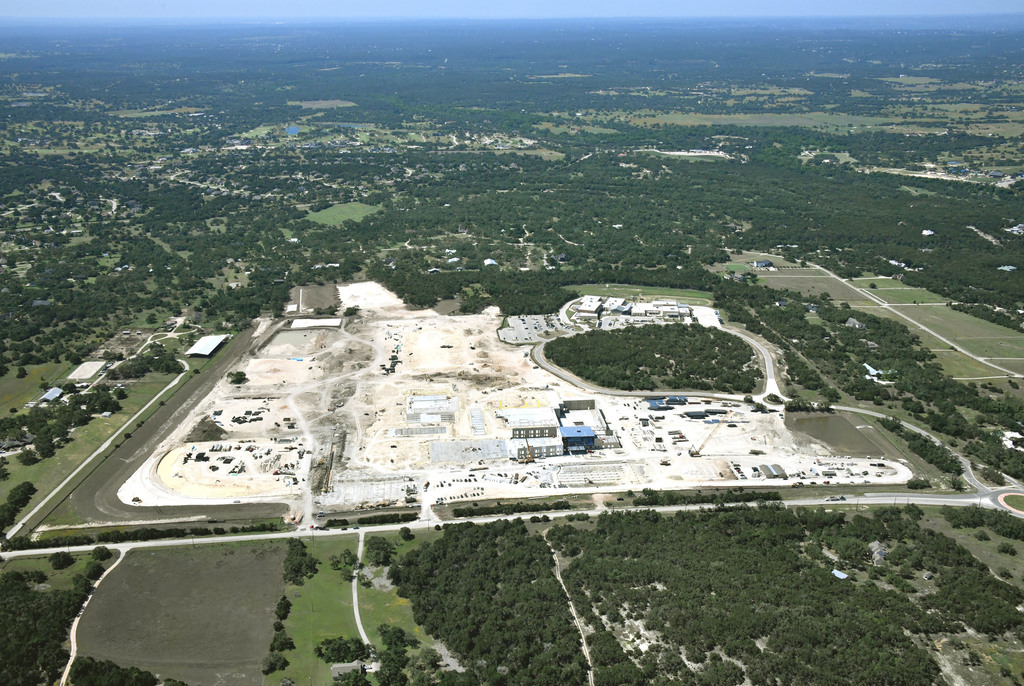

Big things are happening at Driftwood Springs High School! Construction crews are making great progress in the early stages, and we’re excited to see the campus begin to take shape.

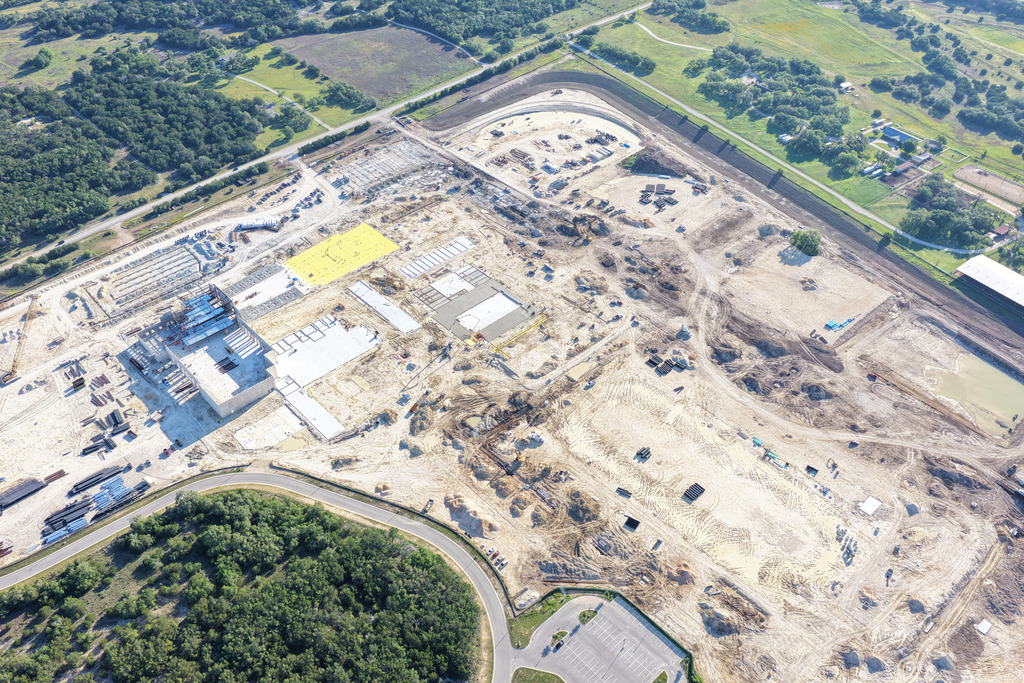

• 99% grading complete
• 75% of the geothermal underground system has been installed

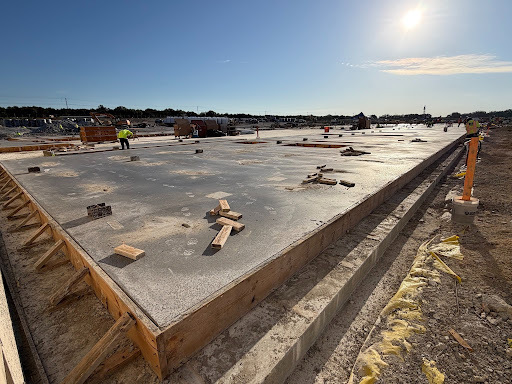

• 75% slab poured
• 25% of tilt walls complete

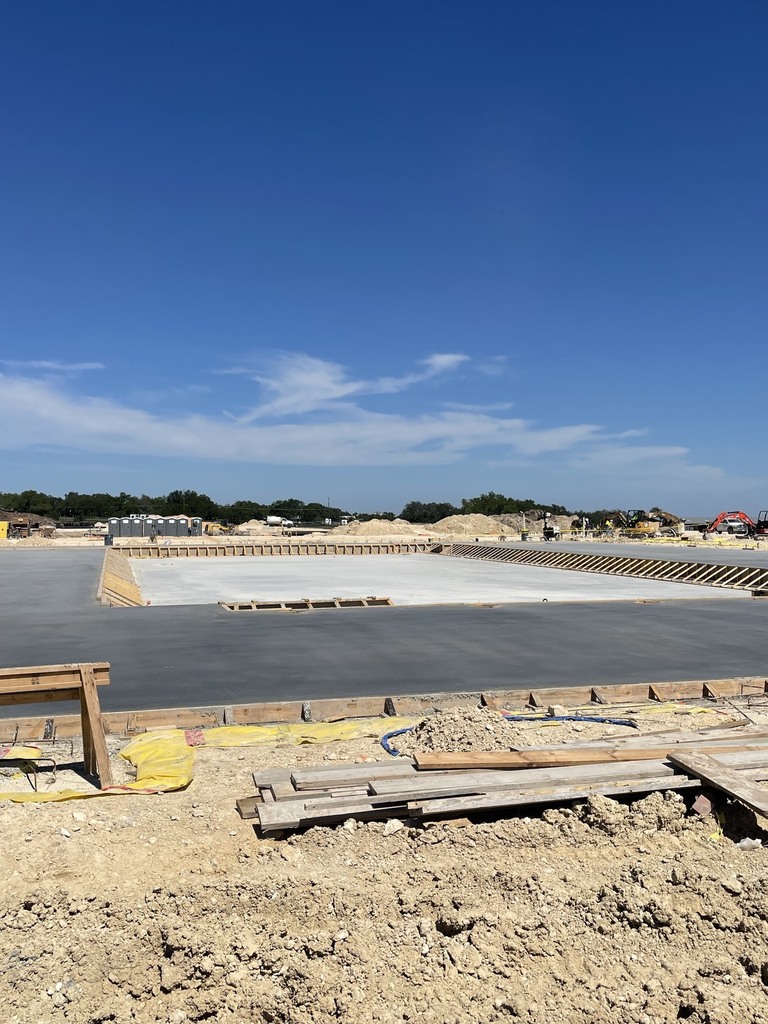

• Gym foundation laid
• Kitchen infrastructure installation underway
• All piers are complete
• Starting the main water line to the campus
6 months ago, DSISD Communications
DSISD proudly celebrated the start of construction on High School #2 with a historic groundbreaking ceremony on Monday evening off Darden Hill Road. 🎉 A huge THANK YOU to our student speakers, the Dripping Springs Middle School cheerleaders, and the Sycamore Springs Middle School band for making this celebration so special! ❤️ We look forward to the bright future ahead! ✨
7 months ago, DSISD Communications
over 1 year ago, DSISD Communications
over 1 year ago, DSISD Communications
over 1 year ago, DSISD Communications
over 1 year ago, DSISD Communications
over 1 year ago, DSISD Communications
over 1 year ago, DSISD Communications
over 1 year ago, DSISD Communications
